Home » Urethane Cement » Surface Prep

Urethane Cement Surface Prep & Substrate Preparation

  • Failure Modes Solved: epoxy delamination from lactic acid (dairy) and brine/blood exposure (meat); tile and grout joint failure under daily caustic CIP; floor-to-wall seam failure where cove base was caulked instead of poured monolithic
  • USDA-FDA Compliance: USDA acceptance for federally inspected meat, poultry, and dairy plants; FDA 21 CFR 175.300 for incidental food contact; cleanable, non-porous surface meets FSIS sanitation standards
  • Thermal Shock: UC accommodates 150°F+ differentials from caustic CIP washdowns hitting cold-room substrate; standard for kill floors, evisceration lines, fabrication, and pasteurizer rooms cycling between production temp and 160°F+ sanitation
  • Chemical Resistance: lactic acid, whey, milk fat, blood, brine, animal fat, and the caustic and quat-based sanitizers used to clean them; the urethane-mortar matrix tolerates the full sanitation chemistry without degrading
  • Integral Cove Base: poured monolithic with the slab to 4-6 inch height; no caulked seams, no quarter-round, no harborage points for USDA inspectors to flag
  • Slip Resistance: broadcast aggregate sized to the area — coarser on kill floors and evisceration lines, finer on packaging and dry-process zones; wet-work safety built into the floor, not added later as a coating
  • HACCP Color Zoning: pigmented topcoat in different colors for raw, RTE, and packaging zones; supports HACCP traffic flow documentation and visual separation auditors expect
  • Surface Preparation: shot blast or diamond grind to ICRI 310.2 CSP 4-5; ASTM F2170 in-situ moisture probe testing before primer; ACI 302.1R substrate tolerances verified
  • Phased Installation: 3-5 day install windows per production area, sequenced around USDA-mandated sanitation cycles; foot traffic returns at 12-24 hours, full chemical service within 72 hours
  • Applications:
    • – kill floors, evisceration lines, fabrication, further processing
    • – RTE, packaging, brine rooms, smokehouses
    • – pasteurizer rooms, tanker bays, cheese vat rooms
    • – yogurt and ice cream lines, cold storage, rendering
  • Crews: in-house W-2 crews mobilized from Dallas; same foreman on estimate and install; no subcontracted mortar placement
  • Pricing: $8-15/sqft installed depending on system thickness, cove base linear footage, drain count, and whether the project includes epoxy or tile demolition

Phone: +1 (844) 687-1961

Email: projects@craftsmanconcretefloors.com

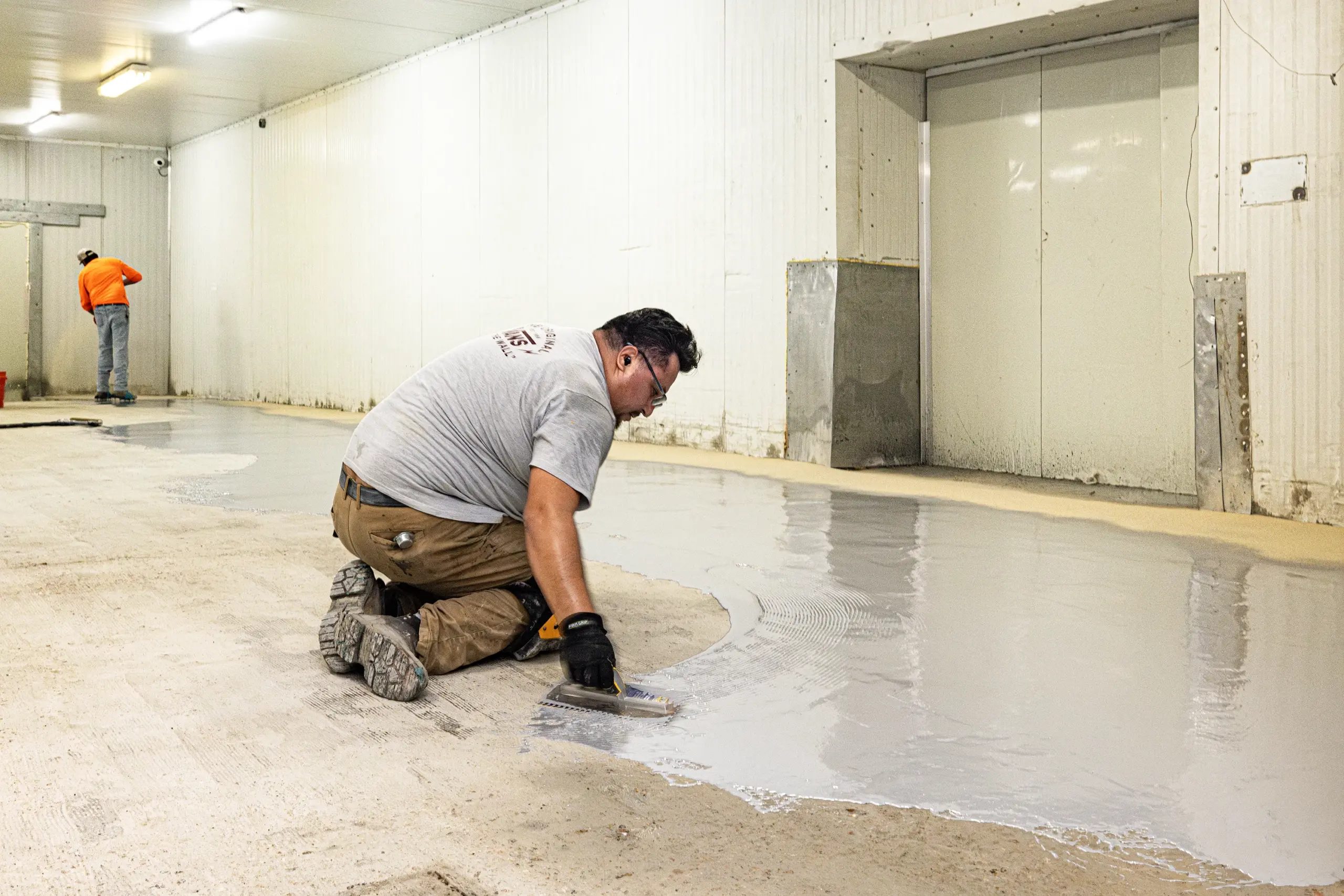

Surface prep is the single biggest variable that determines whether a urethane cement floor lasts 15-20 years or fails inside 36 months. The product matters. The chemistry resistance of the mortar matrix matters. But the substrate the system bonds to is what most UC failures trace back to when Craftsman gets called in for replacement work. Spec engineers and GCs who treat prep as a line item to optimize against — rather than as the load-bearing scope of the project — are the ones whose floors land on the replacement schedule. The product can be perfectly formulated and perfectly installed, and the floor will still fail if the substrate underneath was prepped to a CSP 2 when the manufacturer’s spec called for CSP 4.

The mechanical prep method varies by site condition. Shot blasting is the standard for UC installations and produces ICRI 310.2 CSP 3-5 profiles depending on shot size and machine pass count — steel shot at controlled velocity profiles the concrete, exposes the aggregate, and creates the mechanical key the urethane mortar bonds to. Most UC manufacturer specs require minimum CSP 4; CSP 5 for high-thermal-shock applications where the bond line will see 150°F+ differential cycling. Diamond grinding produces CSP 1-3 and is used where shot blasting isn’t viable — adjacency to sensitive production equipment, low ceilings that can’t accommodate the equipment, or dust restrictions inside active cleanrooms. Diamond grind requires manufacturer-approved primer protocols to compensate for the flatter profile. Scarifying produces CSP 6-9 and is reserved for severely deteriorated or contaminated substrates and removal of failed previous coatings — the aggressive profile requires deeper UC system thickness to fill the texture. Specifying a UC system without specifying ICRI CSP is half a spec.

Moisture is the silent killer of UC installs. ASTM F2170 in-situ relative humidity probes are the standard moisture verification — readings must be below the manufacturer-specified threshold (typically 75-85% RH at 40% slab depth) before primer goes down. ASTM F1869 calcium chloride MVER testing is secondary and less reliable for UC; most UC manufacturers now require F2170 specifically. Substrate repair before UC is its own scope: cracks routed and filled with manufacturer-approved repair mortar, spalls patched, control joints honored or treated per the system’s spec, drains cored and properly transitioned, expansion joints terminated and re-cut after cure. Surface contamination — oils, sealers, curing compounds, prior coatings — gets removed before mechanical prep, with stubborn contaminants like silicate densifiers requiring chemical neutralization before UC will bond. ACI 302.1R substrate tolerances are verified across the full installation area.

Craftsman’s prep discipline is documented at every stage and signed off by the site supervisor. CSP testing with rubber CSP chips after mechanical prep. ASTM F2170 in-situ moisture readings before primer goes down, held for 72 hours minimum. Primer coverage rate confirmed against manufacturer specification. Batch numbers tracked for every product layer. The closeout package carries all of it. In-house W-2 crews mobilize nationwide. Most contractors don’t run this level of QA documentation — and the documentation gap is exactly what cGMP, USDA, FDA, and SQF audits flag during floor qualification. Surface prep itself is included in the $8-15/sqft installed pricing for the UC system; substrate repair scope (crack routing, spall patching, contamination neutralization, drain coordination) is scoped and quoted separately based on slab condition at the consultation walk.

Our Clients

Request a Proposal

Submit project parameters for preliminary analysis. Commercial estimates typically returned within 24 hours.

national

Frequently Asked Questions

Surface prep itself is included in the $8-15/sqft installed UC system pricing — shot blast or diamond grind to manufacturer-required ICRI CSP profile is part of the system installation, not a separate trade. Substrate repair scope is scoped and quoted separately based on slab condition: crack routing and filling, spall patching, contamination neutralization, drain coordination, expansion joint terminations, and any re-slope work all add to the scope depending on what the substrate actually needs. The consultation walk diagnoses substrate condition and confirms the prep + repair scope before the project is quoted.

Most UC failures we get called to replace trace to substrate prep that didn’t meet spec, not product chemistry that failed. The UC product can be perfectly formulated and perfectly installed and the floor will still fail if the substrate underneath was prepped to a CSP 2 when the manufacturer’s spec called for CSP 4. The bond line is where rigid coatings fail — and the bond line is determined by the mechanical key the prep creates. Cementitious urethane has the chemistry and thermal performance to last 15-20 years in production environments, but only if the substrate prep gives the system something to bond to.

ICRI 310.2 CSP 4-5 is the typical range for UC manufacturer specs. CSP 4 is the minimum for most UC products in standard production environments. CSP 5 is specified for high-thermal-shock applications where the bond line will see 150°F+ differential cycling — kill floors, brewhouses, dairy pasteurizer rooms, hot CIP zones. The specific CSP requirement is published by each UC manufacturer (Ucrete, Sika Purcem, Flowfresh, and other major systems each specify their own minimum); the prep matches the chosen system’s spec rather than a generic target.

ASTM F2170 in-situ relative humidity probes are the standard. Probes set in the slab, sealed, and read at 72 hours minimum to allow equilibration. Readings must be below the manufacturer-specified threshold — typically 75-85% RH at 40% slab depth — before primer goes down. ASTM F1869 calcium chloride MVER testing is secondary and less reliable for UC; most UC manufacturers now require F2170 specifically and won’t accept F1869 alone for warranty registration. Moisture readings get documented in the closeout package along with surface profile records and primer coverage rates.

The floor fails at the bond line. Insufficient profile (CSP below manufacturer spec) leaves the UC system without enough mechanical key — the floor can look right on day one and start delaminating at corners and high-traffic zones inside 12-18 months. Excessive moisture (F2170 readings above manufacturer threshold) drives vapor blistering from below within the first heating-and-cooling cycle. Surface contamination not removed before prep — silicate densifiers, sealers, oils — prevents bond entirely, and the topcoat lifts in sheets the first time the floor sees thermal cycling. Documented prep is what separates 15-20 year service life from 24-month replacement.

Nationwide installation. Estimating and scheduling coordinated through Dallas headquarters. In-house W-2 crews mobilized to project sites. Craftsman Concrete has been installing industrial flooring since 1999.
